How to Create Design Specifications for Development In hospitality, senior living, and multi-family projects, the gap between a designer's creative vision and what actually gets built comes down to one document: the design specification. Most design packages stop short of it. The firm delivers the look — palettes, renderings, mood boards, a material direction — and someone downstream is left to go find the actual products that will survive a hotel corridor, pass a fire marshal's review, and still land inside the owner's budget.

That downstream work is not free. It is a second sourcing effort, paid for a second time, running on a schedule that has already started. And when specs are vague, incomplete, or issued at the wrong time, the consequences show up fast — contractor errors, procurement substitutions, budget overruns, and installation sequences that have to be redone.

Construction quality deviations — including rework, redesign, and replacement — average 12.4% of total installed project cost, according to the Construction Industry Institute. A significant share of that figure traces back to specification failures, not field execution.

This guide covers exactly how to create FF&E design specifications for development projects: what to include, how to structure them, what determines their quality, and the mistakes that derail even well-planned projects.

Key Takeaways

  • Design specifications translate design intent into precise, actionable instructions for procurement teams, contractors, and installers
  • A "look" is not a specification — a palette and a rendering still leave every product decision unmade, and someone has to pay to make them later
  • A complete spec covers functional requirements, materials, dimensions, compliance standards, and coordination notes — beyond aesthetics alone
  • Specs belong at Design Development completion for budgeting and at Construction Documents for procurement
  • Vague language, missing measurements, and specs written without procurement input are the most common failure points
  • Specifying real products during design, rather than after it, gives owners a line-item budget early and removes an entire round of sourcing, re-pricing, and substitution

What Are Design Specifications in an FF&E Development Context?

Design specifications in physical development are documented descriptions of every fixture, finish, furnishing, and equipment item to be procured and installed. They define what each item is, how it must perform, what it must look like, and how it fits into the broader project environment.

Unlike digital UX specs, FF&E specs govern tangible environments — a hotel guestroom, a senior living dining area, a multi-family amenity lounge.

Two Levels of Specifications

Commercial development projects typically use two tiers:

  • Preliminary specifications — issued during Design Development to guide budgeting and procurement sourcing. Per AIA's definition of basic services, DD deliverables include outline material specifications and are used for trade-breakdown cost estimates and owner approval.
  • Final construction specifications — issued at Construction Documents as the binding procurement and build-to document. AIA describes CD specs as containing comprehensive specifications and all information a contractor needs to price and build the project.

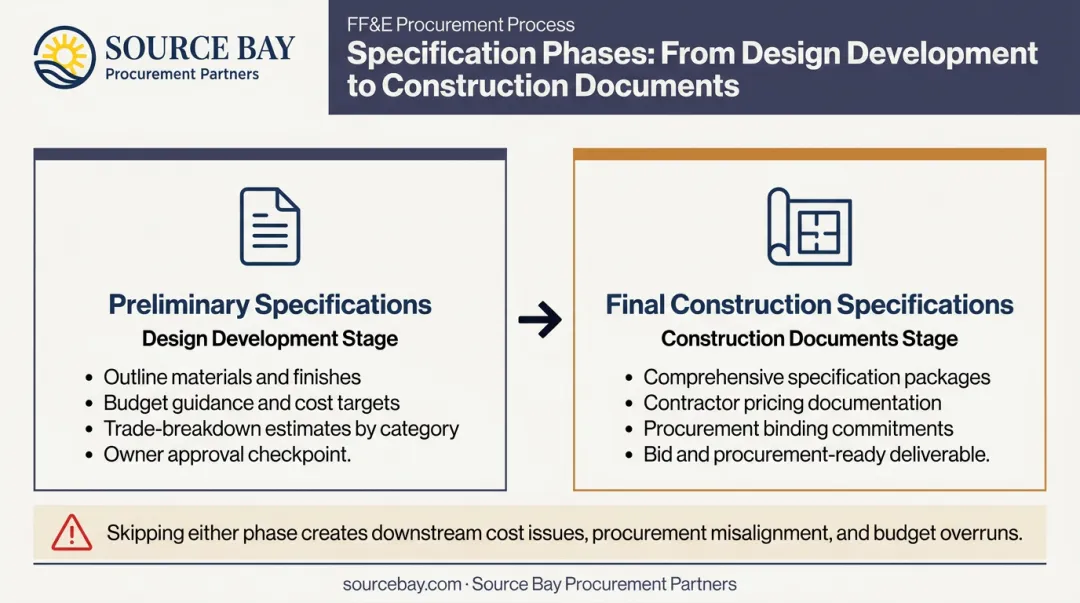

Two-phase FF&E specification timeline from Design Development to Construction Documents

Skipping either phase creates downstream cost and coordination problems that are difficult to recover from mid-project.

Who Uses These Documents

Interior designers and architects author FF&E specs, but the audience is broader:

  • FF&E procurement managers source products against them
  • General contractors coordinate rough-ins and sequencing from them
  • Project managers track budget and schedule against them
  • Installation crews execute from them on-site

Each of these stakeholders reads the same document for a different purpose — which is why clarity, completeness, and consistent formatting matter as much as the technical content itself.

The Gap Between a "Look" and a Specification

On most hotel new builds and renovations, the design firm's contract ends at design intent. The deliverable is a set of renderings, a finish direction, and a furniture layout showing a shape that reads as "lounge chair." What it does not contain is the chair: no manufacturer, no model, no frame construction, no rub count, no COM grade, no lead time, no price.

Someone has to close that gap. Usually it is the owner's purchasing agent, the operator's project team, or the ownership group itself — people now searching for commercially appropriate products that match a rendering, months after the design was approved.

What That Handoff Actually Costs

Consequence of specifying after design Effect on the project
A second team re-selects every item Duplicate fees for work the design firm was already closest to
Budgeting runs on per-key allowances Owners cannot price the project until sourcing is nearly done
Renderings show products that don't exist commercially Substitutions begin immediately, and the design drifts
Lead times are discovered after selection Long-lead items collide with an opening date already set
Design intent is interpreted, not documented The finished space stops matching what was approved

None of this is a failure of the design. It is a failure of sequencing. The information needed to specify a product correctly — what the space is for, how hard it will be used, what it must cost — is all present during design. Deferring the decision does not make it easier; it just makes it someone else's, later, with less context and less time.

Designing and Specifying in the Same Pass

The alternative is to treat product selection as part of design rather than a downstream consequence of it. When the designer choosing the palette is also naming the manufacturer, the model, the fabric grade, and the finish code, three things change:

  • The budget becomes real immediately. Line-item pricing replaces allowances, so owners, lenders, and brands can underwrite the project off the design package.
  • The product is commercially appropriate by construction. Rub counts, BIFMA ratings, cleanability, and ADA clearances are constraints on the selection, not tests it has to pass afterward.
  • Nothing is re-selected. The spec book that documents the design is the same document procurement buys from.

This is the model Source Bay Procurement Partners works in: design and specification issued together, so the product in the drawing is the product that arrives on the truck. The rest of this guide covers how to build that specification correctly.

How to Create Design Specifications for Development

Step 1: Establish the Project Brief and Design Intent

Before writing a single spec entry, confirm the foundational documents exist: the design concept narrative, space-by-space programming, brand standards if applicable, and the overall project budget envelope.

Specs written without a clear brief drift in scope and miss critical constraints. The brief is the foundation every specification entry builds on — skip it, and every decision downstream becomes a guess.

Create a master list of all FF&E categories to be specified organized by space:

  • Hospitality: guestrooms, corridors, lobby, dining, bar, fitness, meeting spaces
  • Senior living: resident rooms, common areas, dining, memory care, outdoor
  • Multi-family: lobby, amenity lounge, fitness, corridors, model unit

This master list prevents items from falling through the cracks during the specification process.

Step 2: Define Functional and Performance Requirements

For each item category, document what the product must do, not just what it must look like.

A lobby seating spec, for example, should include:

Fire and safety compliance must be documented before design decisions lock in:

  • California TB-117-2013 and the federal SOFFA standard for upholstered furniture smolder resistance
  • NFPA 260 and 261 for cigarette ignition resistance in applicable occupancies
  • NFPA 101 for life safety, reviewed against the adopted code and local authority having jurisdiction

ADA requirements for senior living and applicable hospitality spaces include:

  • Accessible dining/work surface tops at 28 in. minimum to 34 in. maximum above finish floor (ADA Section 226/902)
  • ADA bench seat height 17–19 in., depth 20–24 in., length 42 in. minimum (Section 903)
  • Clear floor space 30 in. × 48 in. minimum (Section 305)

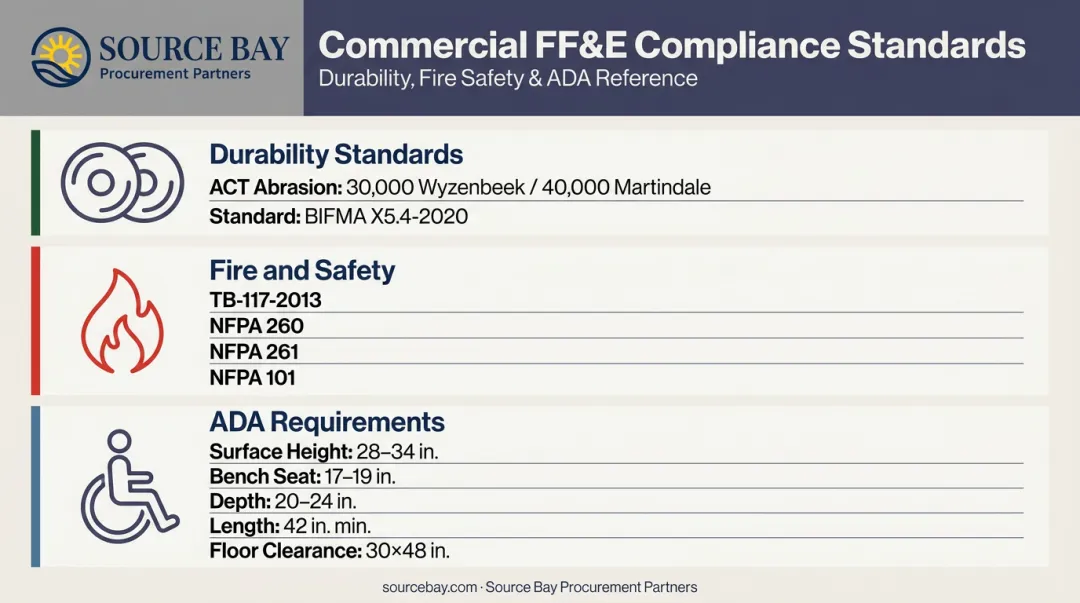

FF&E compliance standards checklist covering fire safety ADA and durability requirements

Step 3: Specify Materials, Finishes, Products, and Dimensions

This is the step that separates a design package from a specification. Every material, finish, and product choice needs enough precision that procurement can buy it without a follow-up call to the design team — and enough commercial rating that it belongs in the space at all:

  • Fabric names, colorways, vendor, and item numbers
  • Finish codes for metal and wood components
  • Paint colors with manufacturer name and formula reference
  • Tile selections with ANSI A137.1:2022 variation class (V0–V4) noted where shade variation matters
  • Stone selections with slab and dye lot notes
  • Dimensions: height, width, depth, seat height, and clearances for all furniture and fixtures
  • Current unit price and quantity per space, so the specification doubles as the FF&E budget

For every named product, include an approved-equal clause. CSI Form 1.5C establishes that substitutions must be demonstrated as equal or superior across physical characteristics, in-service performance, expected durability, visual effect, and sustainable design features.

Be explicit about what is non-negotiable (silhouette, color family, fire rating) versus what can flex (specific manufacturer, hardware finish detail).

Step 4: Document Coordination, Installation, and Procurement Notes

Coordination notes are the step most commonly missing from specs — and the one that causes the most expensive surprises on-site.

Include:

  • Electrical rough-in specs for all hardwired lighting fixtures
  • Blocking requirements in walls for grab bars, hardware, and mounted case goods
  • Floor load ratings for heavy case goods or equipment
  • Sequencing notes for items that must be installed before others are placed

Flag long-lead items explicitly in the spec. Based on hospitality procurement data, custom lighting typically runs approximately 17 weeks, domestic casegoods 12–16 weeks, and overseas/imported casegoods 16–18 weeks.

Custom upholstery and commercial textiles require direct confirmation with the mill or manufacturer — particularly as import tariff conditions continue to affect FF&E pricing and lead times.

What to Include in a Design Specification Document

A complete FF&E spec document is organized by space or item category. Every entry should follow a standardized format.

Required Fields for Each Spec Entry

Field What to Document
Item name and category e.g., "Guestroom Lounge Chair – Soft Seating"
Design intent description Functional and aesthetic purpose in the space
Manufacturer / vendor Primary selection with approved-equal criteria
Model or SKU Specific reference number
Finish / colorway With vendor codes, not descriptive language
Dimensions H × W × D, seat height, clearances
Quantity per space Unit count and total
Performance requirements Rub count, weight capacity, BIFMA standard
Compliance standards ADA section, TB-117, NFPA rating
Installation notes Electrical, blocking, sequencing
Lead time flag Custom vs. stock; estimated weeks

FF&E specification document template showing structured item entry fields and data

Visual and Material References

Attach annotated finish schedules and mood boards as supporting documents. They clarify intent, but they do not replace the written spec. A procurement team working from a mood board alone will interpret color, texture, and material differently than the design team intended — and those gaps show up on installation day.

Version Control

Every spec document must include:

  • Version number and issue date
  • Change log tracking what was revised and when
  • Distribution record noting who received which version

Verbal design updates that never enter the written spec are a leading source of procurement errors — the kind that surface when 40 guestroom chairs arrive in the wrong finish because a finish change was communicated by email but never formally documented. When a design decision changes, update the spec, issue a new version, and confirm receipt with the procurement team.

Key Factors That Affect the Quality of Design Specifications

Specificity and Measurability

The single most important quality of a spec is that every requirement can be objectively verified. Avoid language like "high-quality," "durable," or "appropriate finish." Name the standard, the measurement, or the test method.

If a requirement can't be verified during QA, it won't hold up when disputes arise — and it won't protect the project.

Whether Specification Happens During Design or After It

This is the single biggest driver of spec quality, and it is decided before a word is written.

Specs produced in isolation by design teams, without procurement input, routinely include items that are discontinued, carry prohibitive lead times, or price well beyond the project budget. Specs produced after design by a separate sourcing team have the opposite problem: the products are buyable, but nobody documented why the original selection looked the way it did, so intent erodes item by item.

Doing both at once avoids each failure. Source Bay Procurement Partners' Discovery phase establishes budget, brand standards, and operational requirements before selection begins, and its designers then specify against those constraints while the design is still being drawn. Every selection is validated for availability, compliance, price, and deliverability at the moment it is made — not revisited after the design is locked.

For an owner, the practical difference is that a fundable, line-item FF&E budget exists at Design Development instead of months later.

Timing Within the Development Schedule

  • Too early: Specs issued before design is resolved require costly revisions
  • Too late: Specs issued after procurement should have started compress the sourcing window and increase substitution risk

The AIA framework is a reliable guide: preliminary specs at Design Development completion, final specs at Construction Documents. The window between these two phases should be used to validate long-lead selections, confirm budget alignment, and resolve any compliance gaps.

Common Mistakes When Creating Design Specifications

Writing Vague or Unmeasurable Requirements

"Comfortable seating" and "neutral palette" are not specifications. They are design aspirations. Every requirement must be specific enough that a contractor, manufacturer, or installer can verify compliance without calling the design team for clarification. If a requirement can't be measured or verified on-site, it isn't a specification — it's a wish.

Failing to Update Specs After Design Changes

Design evolves throughout a development project. Spec documents often don't evolve with it. When the design file diverges from the issued spec, procurement teams work from outdated information — and the discrepancy typically surfaces at installation, not before.

A formal change management process prevents this. When any design revision affects a procured item:

  • Issue a spec revision with a version number and date
  • Update all affected line items in the procurement schedule
  • Notify relevant stakeholders before sourcing continues

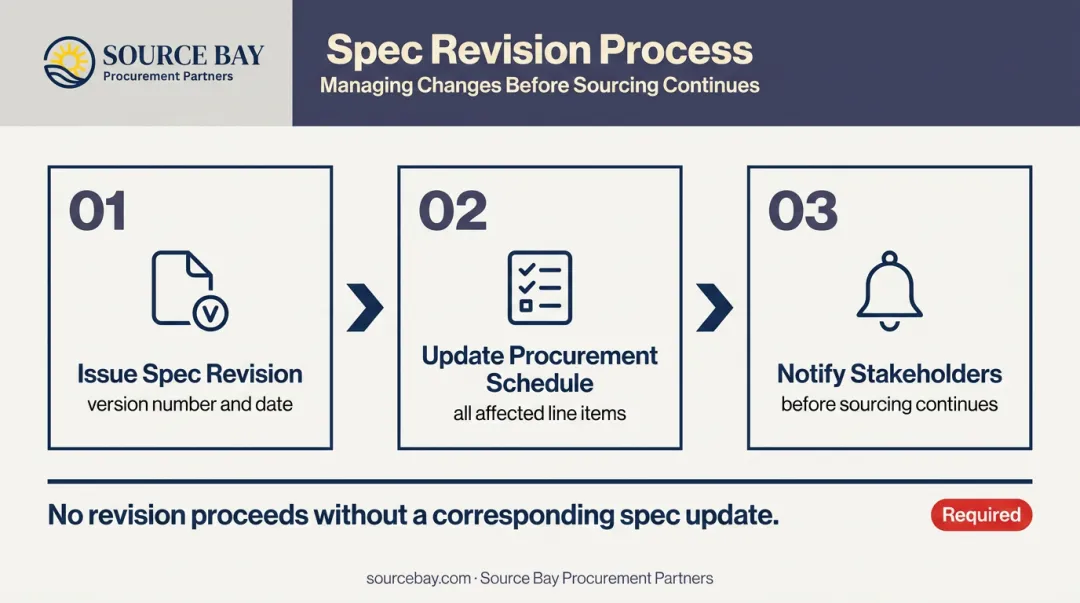

Three-step design specification change management process flow for FF&E projects

No revision should proceed without a corresponding spec update.

Ignoring Lead Times During Specification

Specifying a custom fixture with a 17-week lead time on a project with a 12-week procurement window is a spec failure — not a procurement failure. Realistic lead time planning belongs in the specification phase, not the sourcing phase.

On compressed schedules, the spec should proactively identify stock or near-stock alternatives for high-lead-time items. Source Bay works directly with manufacturers like Remington Lighting, Kellex Furniture, and Blue Leaf Hospitality to find those alternatives early — before procurement timelines are already broken.

Frequently Asked Questions

What is an example of a design specification?

A hotel guestroom lounge chair spec might read: "Manufacturer: [Brand], Model: [SKU], seat height 18 in., Grade B COM upholstery in [Fabric Name, Colorway], TB-117-2013 compliant, BIFMA X5.4 compliant, approved equals must match silhouette and seat height." That is a specification. "A comfortable chair in a warm tone" is not.

Do interior design firms specify the actual products?

Often not. Many commercial design firms deliver design intent — layouts, palettes, renderings, and a material direction — and leave product selection to the owner's purchasing agent or an FF&E procurement firm. Some firms do specify down to the manufacturer and model. It is worth confirming which you are buying before the contract is signed, because the difference determines whether you receive a budget or an allowance.

Should the same firm design and specify?

It is generally cheaper and faster when one firm does both. Splitting the work means a second team re-selects items the first team already had the context to choose, which duplicates fees, delays the budget, and introduces substitutions that pull the finished space away from the approved design. A combined engagement produces one document that serves as design record, procurement package, and budget.

What are the four types of specifications?

CSI defines four specifying methods: descriptive (physical characteristics, no brand named), performance (outcomes the item must achieve), reference standard (a published standard it must meet), and proprietary (a named manufacturer or product, with or without substitution allowances).

What should be included in an FF&E design specification?

Every entry should cover:

  • Item name, manufacturer, and model reference
  • Dimensions and quantity per space
  • Materials, finishes, and vendor codes
  • Performance requirements and compliance standards
  • Installation or procurement coordination notes

Who is responsible for writing design specifications on a development project?

The interior designer or architect authors the specifications. The FF&E procurement manager or procurement partner reviews them for sourcing feasibility and lead time viability. The project manager confirms alignment with the construction schedule and approved budget. Where design and procurement sit with the same firm, authoring and feasibility review happen simultaneously rather than in sequence.

How detailed should design specifications be?

Detailed enough that any qualified contractor or procurement professional can source, procure, or install the item without further clarification from the design team. Every dimension, material code, finish reference, and performance requirement should be explicitly stated.

When should design specifications be finalized?

Preliminary specs should be complete at Design Development, supporting budget validation and early sourcing conversations. Final specs are due at Construction Documents to initiate procurement. Use any gap between phases to confirm lead times, availability, and compliance.
